Turn your job's task list into a Gantt chart you can print and share. List phases, tasks and milestones, then type when each task starts and how many work days it takes. Finish dates work themselves out, skipping weekends and your holidays, and the bars draw themselves on the timeline. Mark each task Not started, In progress, Done or Blocked, and the chart shows where the job stands.
Excel 2010 or newer
Microsoft 365
Excel Table · grows as you add lines
No macros
Nothing locked
Built for builders and trades who run a job week to week and need one schedule everyone can read. It's set up for construction, but it works for any project with tasks, dates and people doing the work.
Sample jobs for illustration. Numbers vary by market.
01
Type a start date and a number of work days. Finish works itself out and the bar fills the timeline. Pick ◯ for a phase, ◆ for a task and ★ for a milestone, and the codes number themselves.
02
Set your work week and holidays on Setup once. Every finish date skips your days off, and a task that starts on a weekend counts from the next work day.
03
Switch between 26 weeks and 26 days, with weekends and holidays shaded. Start the chart on any week to look ahead, then print it landscape for the site meeting.
04
Set each task to Not started, In progress, Done or Blocked, and its bar changes to match. The top of the sheet shows % complete by work days, the finish date and how many tasks are done.
Guide
Why I built a construction project tracker
One of the biggest ways a contractor loses money on a job is poor planning. That was definitely a problem in our general contracting business.
My dad was the GC. He was also the superintendent, the project manager and the estimator. Every phase of every project went through him, so he naturally became the bottleneck. His plans were never written down. They were all in his head. When a sub called to ask when they could start, the answer depended on whether they could reach him.
That's a recipe for inefficiency. A crew shows up before the area is ready, or an inspection gets called a day late, and the job loses a day. Lose enough days and the money goes with them.
So I put this project tracker together. We're a small business, so we couldn't afford expensive software with fancy Gantt charts and kanban boards. Building this spreadsheet was easy, and it gets the job done. With it, we can see what task is next, what's coming up and who's responsible for what.
What is a construction schedule?
A construction schedule is the plan for when each part of the job happens, in order. It breaks the job into phases, like site work, concrete and framing, then into the tasks inside each phase, each with a start date, a duration and who's doing it.
It also marks the milestones: the dates that aren't work so much as checkpoints. Notice to proceed, a foundation inspection, dry-in, final inspection and owner handoff.
The most common way to show it is a Gantt chart. Each task is a bar on a timeline, so you can see at a glance what's happening this week, what overlaps and what's coming up next. A schedule in a list tells you the dates. A Gantt chart shows you the job.
How to build a construction schedule, step by step
List the phases. Follow the job the way it gets built: pre-construction, site work, concrete, structure, roofing, mechanical and electrical, closeout.
Break each phase into tasks. One line per piece of work a crew can start and finish.
Give each task a duration in work days. Not calendar days. A 10-day task that starts on a Monday finishes two weeks later, not 10 days later.
Set the start dates. Each task starts when the work it depends on is far enough along. That's where your experience comes in.
Add the milestones. The inspections and handoffs that everything else has to line up with.
Put a name on every task. The sub, the crew or the person responsible.
Update it every week. Mark what's done, what's in progress and what's blocked, and move the dates that slipped.
In the template, you do steps 1 through 6 once and step 7 every week. The finish dates, the bars, the % complete and the task count work themselves out.
A construction schedule example with real numbers
Here's the sample schedule that comes in the file: Northline Construction building a shell and site package called Harbor Plaza. It's the same job as the samples in the Bid, Schedule of Values and Job Costing templates.
The plan. 7 phases and 25 tasks and milestones, from notice to proceed on November 2, 2026 to owner handoff on April 23, 2027.
Where it stands. 11 of 25 are done, and the job is 44% complete by work days. The site work is done except paving, the foundation passed inspection, and the steel is up.
What's happening now. Metal stud framing, exterior sheathing and the roof are in progress. Electrical rough-in is moving. Plumbing rough-in is blocked, and its bar shows stripes, so it's the first thing anyone looks at in the site meeting.
What's coming up. Dry-in is the next milestone, on February 22. The HVAC rooftop units start March 1 and the fire sprinklers March 8. Asphalt paving waits until March 29.
Who's responsible. Every line has a trade: the sitework sub, the steel sub, the framing crew, the inspector, the owner. Nobody has to ask who's on the hook for a task. It's on the line.
A construction Gantt chart in Excel

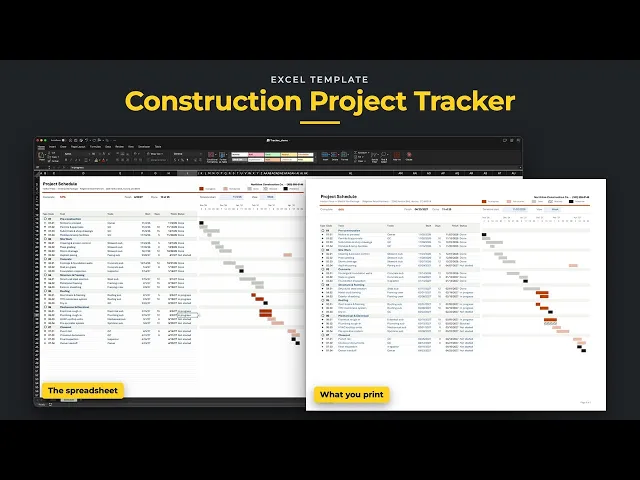

The Schedule tab is a Gantt chart that draws itself. Type a start date and the number of work days, and the finish date works itself out and the bar fills the timeline.
Phases, tasks and milestones. Pick ◯ for a phase, ◆ for a task and ★ for a milestone. Codes like 04.02 number themselves.
Status colors. Not started, In progress, Done and Blocked each have their own look. Done bars go gray, and Blocked bars get stripes.
Week view or day view. The timeline shows 26 weeks for the whole job, or 26 days for a close-up. Weekends and holidays are shaded.
Look ahead. Start the timeline on any week. Pick next Monday and the chart becomes a look-ahead for the next six months, or the next few weeks in day view.
One printed page. It prints landscape for the site meeting or the owner. The sample fits on one page, and a longer schedule repeats its headers on every page.
The top of the sheet shows % complete, the finish date and how many tasks are done.
Work days, not calendar days
Construction runs on work days. Weekends and holidays don't count, and a schedule that counts them is wrong from day one.
On Setup, you pick your work week (Monday to Friday, Monday to Saturday, or every day) and list your holidays. Every finish date skips your days off.
In the sample, clearing and erosion control starts Monday, November 23, and takes 5 work days. Thanksgiving and the Friday after are on the holiday list, so it finishes on Tuesday, December 1, not Friday, November 27. You don't count that out on a calendar. The sheet does.
A task that starts on a weekend counts from the next work day, and the holiday list comes with sample US dates you can change to your own.
Construction schedule template for Excel: what's in the file
This construction schedule template has two tabs.
Setup. Your company, the project, the client, the superintendent, the work week, the holidays and one accent color. You fill it in once.
Schedule. The task list and the Gantt chart side by side. Each line has a type, code, task, trade, start, days, finish and status.
Use one file per project, with about 490 lines ready to fill. Type in the blue cells only. Everything in black calculates, and there are no macros.
The download comes with a blank file and the Harbor Plaza sample, plus a PDF guide, in two editions: one for Excel 2021 and newer, and one for Excel 2010 and newer.
It's built for construction, but it works for any project with tasks, dates and people doing the work.
Project management software or a spreadsheet?
Project management software does more. It can move every task after a delay on its own, send reminders, and let the crew update it from their phones. If you run a lot of jobs with a dedicated scheduler, it may be worth the monthly fee.
For a small contractor, most of that goes unused. What you need is one schedule everyone can read, that's easy to keep current, and that prints for the meeting.
That's what this is, with one honest difference. Tasks don't push each other. When a task slips, you change its days, then retype the start of the tasks that follow it. On a 25-task job, that's a minute, and it keeps you looking at what actually moved.
The tracker also doesn't use today's date. There's no today line and no late flag. You plan ahead and look back, and a date that changes every time you open the file would be wrong more often than right.
Using it every week
The schedule only helps if it stays current. The routine is short:
Open the file before the weekly meeting.
Mark what got done and what started.
Mark anything blocked, so it stands out.
Fix the dates that slipped.
Set the timeline to start this week, and print it.
Hand that page around the table and everyone sees the same thing: what's next, what's coming up and who's responsible. The plan isn't in one person's head anymore.
Construction project tracker FAQ
Is there a free version?
No. It's an Excel file, not software, so there's no way to give you a limited version. Cutting rows, formulas or tabs would just hand you a spreadsheet that doesn't work. You get the whole file as part of the template library: $97, one time, for every template.
Does it work in Google Sheets?
No. It's built for Excel only.
Which versions of Excel?
The download has two editions: one for Excel 2021 and newer, and one for Excel 2010 and newer.
Does it work on a Mac?
Yes, in Excel for Mac.
If one task slips, do the others move?
No. Change the slipped task's days, then retype the start of the tasks after it.
Does it show what's late?
No. There's no today line or late flag. Mark each task's status every week, and Blocked tasks stand out with stripes.
How many tasks fit?
About 490 lines in one file, and you can add more.
Can I use it for projects that aren't construction?
Yes. It's set up for construction, but any project with tasks, dates and people doing the work fits.
