How to Build a Construction Bid Template in Excel That Actually Works
The formulas and logic behind a construction bid template in Excel with auto category totals, a print-controlled client estimate, and a built-in terms sheet.

Article written by
Stephen S.

Most bid spreadsheets are just a list of numbers. Add your costs, apply a markup, send it out. That works until you forget a line item, misapply a margin, or realize your client-facing estimate is out of sync with your working numbers.
When I built a construction bid template in Excel for my dad's contracting business, I wanted it to solve those problems at the source. This post walks through the specific decisions behind how it's structured: the formulas, the logic, why certain things work the way they do. Not every line, just the parts that matter most.

How to Organize Line Items: The ◯ and ◆ System
The first problem I had to solve was structure. A real construction bid isn't a flat list. It has categories: General Conditions, Site Work, Framing, Electrical, and so on. Inside each category are the actual line items. You need the template to understand that hierarchy, not just display it.
I solved this with a single Type column. Each row gets a dropdown with two choices: ◯ or ◆.
◯ is a category header. ◆ is a line item.
That's it. One column, two values. But it drives almost everything else in the template.
The first thing it does is formatting. A conditional format rule bolds any row where the Type cell equals ◯. So category headers are always bold, line items never are. You don't have to set that manually. Add a new category, select ◯, it bolds itself.
The second thing it does is math, and that's where it gets more useful.

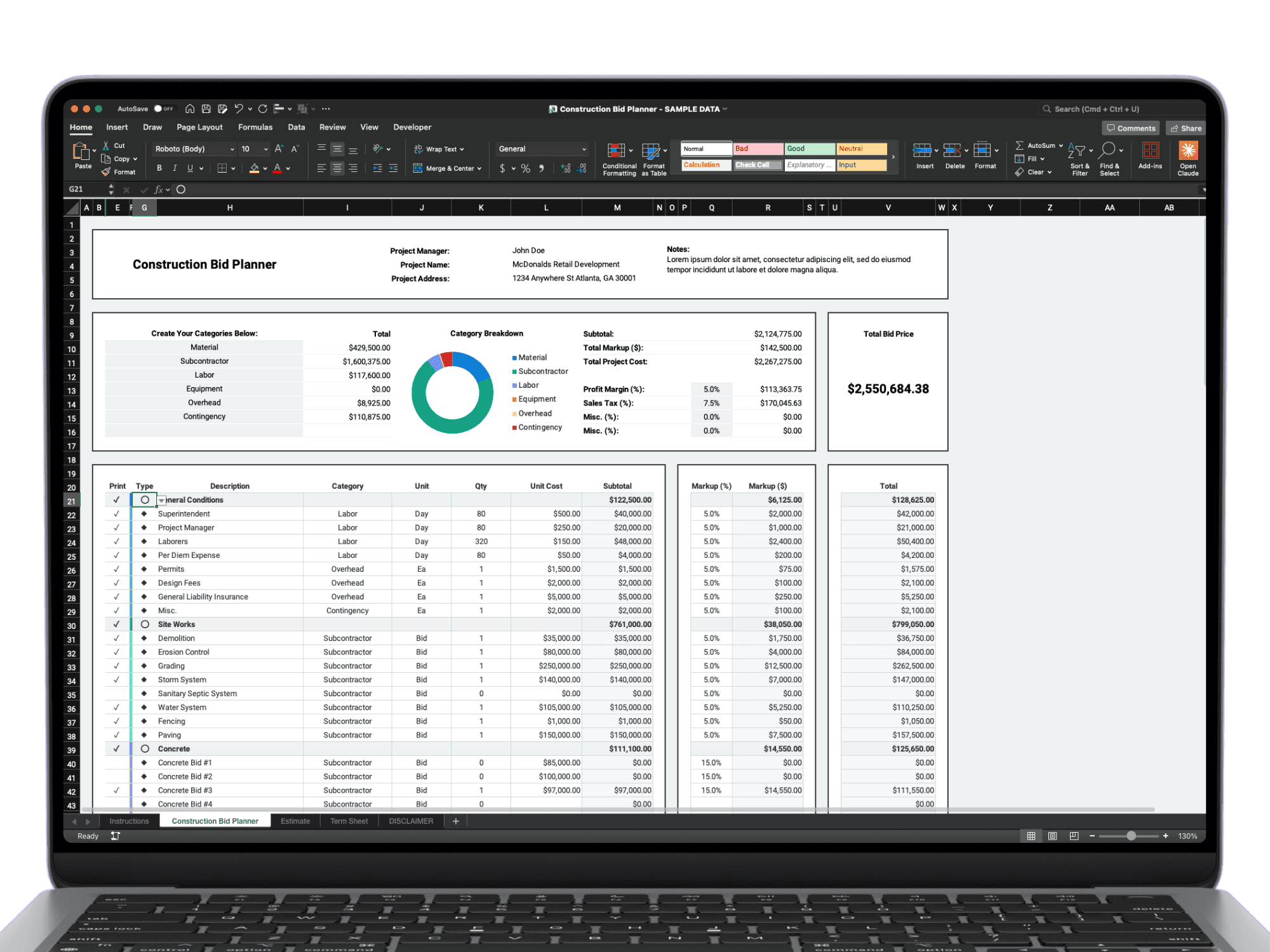

How to Make Category Totals Roll Up Automatically in Excel
When you're building a construction bid across dozens of line items, you want each category header to show the total for everything underneath it. You don't want to maintain those totals manually. Change a number three rows down and the header should update on its own.
Here's the subtotal formula on a header row (◯):
I know that looks like a lot. It's not, really. Most of it is error handling and edge cases. The part that actually matters is one line.

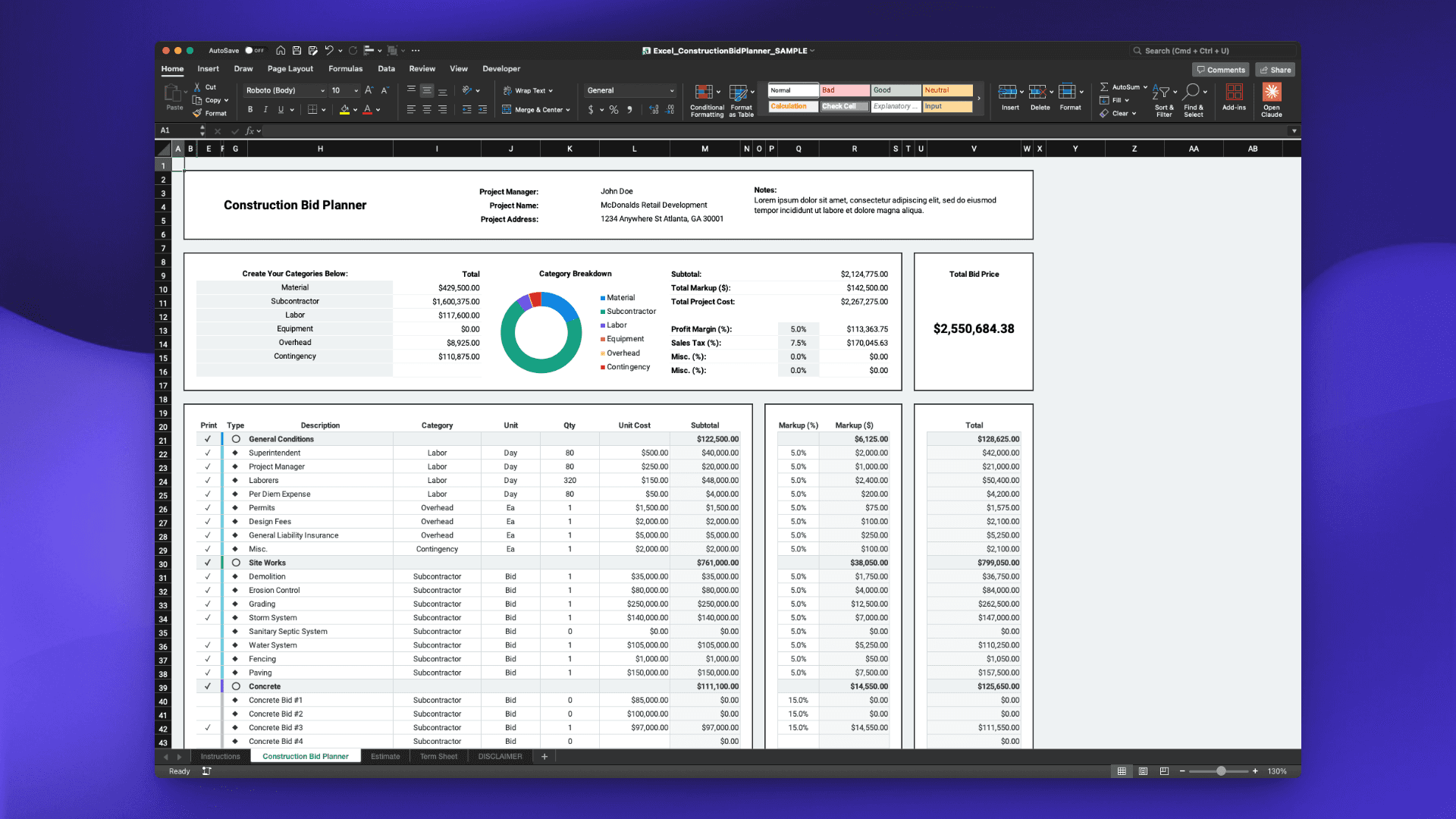

The key part is IF($G21="◯". When that condition is true, meaning this row is a category header, the formula runs a SUMIFS that pulls in every ◆ row in the same category. When it's false, a regular line item, it just calculates Qty × Unit Cost.
Same logic carries through to markup and total:
To see it in action: add a unit price to a line item and the category subtotal updates on its own. Add a markup percentage and the markup total and overall total follow. Every number in the header rows is driven by what's in the line items below. You never type into them directly.
How to Auto-Populate a Client Estimate from Your Working Sheet

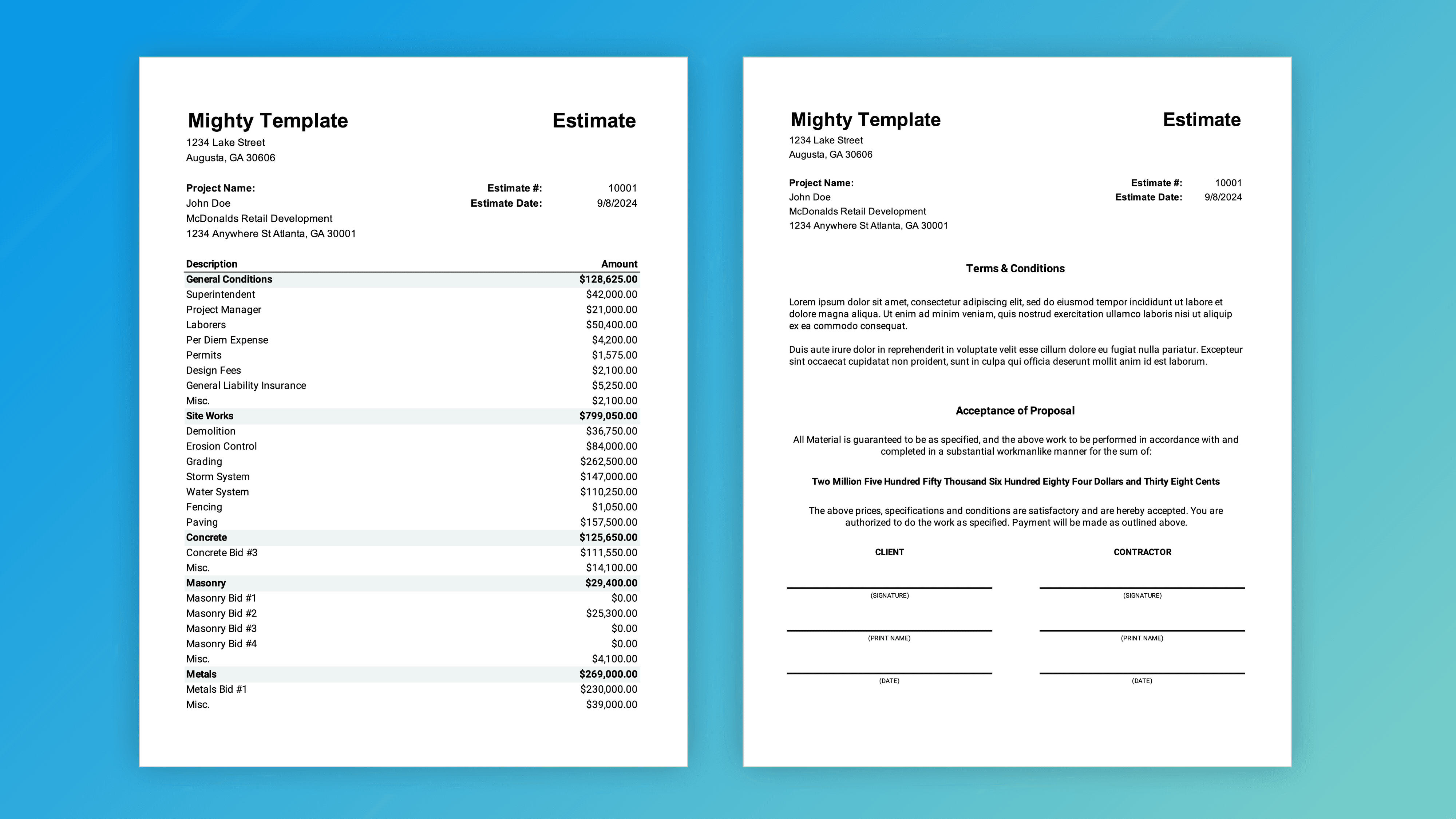

Once your working sheet is built out, you need a client-facing estimate. The working sheet has everything: multiple subcontractor quotes, internal notes, cost breakdowns the client doesn't need to see. The estimate tab should only have what you're actually sending out.
That's what the Print column handles. It's a simple checkbox. Check a row and it shows up on the estimate. Uncheck it and it doesn't.
This becomes useful fast when you're comparing subcontractor bids. Say you've got four concrete quotes. You enter all of them in the working sheet, one per row. When you pick one, you check it. The other three stay unchecked. The estimate only pulls the one you want.
The formula on the estimate tab that makes this work is different depending on which version you're using.
Google Sheets:
Excel:
Both do the same thing: filter the working sheet to only rows where the Print column is checked, then pull the columns you want onto the estimate tab. The syntax is different because ARRAYFORMULA doesn't transfer cleanly from Sheets to Excel, so each version was built natively for its platform rather than forcing a workaround.
The result is that you never manually build the estimate. You build the working sheet, check the rows you want, and the estimate assembles itself.
The Terms Sheet: Where the Bid Becomes a Contract
Most construction bids end at the numbers. You send a price, the client says yes, and everyone hopes they're on the same page about the rest. That gap is where disputes start.
The third tab is a terms sheet. It pulls your company info and project details from the working sheet, states the total contract amount in full, and gives both parties a place to sign. There's also a Terms and Conditions section where you can spell out payment schedules, change order policies, warranties, or anything else that needs to be in writing before work starts. If your projects use progress billing, the schedule of values template handles pay applications and retainage tracking separately from the bid.
It's a page most small contractors don't include, not because they don't need it, but because nobody built it into the bid. Having it in the same file means there's no separate document to track down, no version confusion, no sending a price sheet and a contract as two different attachments. The client gets one file that covers the whole thing.

Why This Structure Works
None of these features are complicated on their own. A SUMIFS, a FILTER, a conditional format. But together they solve a real problem: the bid and the estimate stay in sync without any manual work to keep them that way.
Most contractors I've talked to are either maintaining two separate files, one for their numbers and one to send to clients, or copying and pasting between tabs and hoping nothing's off. Both create chances for errors. A number changes in one place and doesn't get updated in the other.
This template has one source of truth. The working sheet. Everything else, the category totals and the client estimate, reads from it automatically.
Once the bid is accepted and work starts, the next thing that usually drifts is actual costs versus what you quoted. The job costing tracker picks up where the bid leaves off.
The Full Build
This post covers the logic behind the structure, not every formula in the file. I wrote a similar walkthrough for the construction Gantt chart, covering how the scheduling, Kanban, and calendar views work together. If you want to dig into the full thing, the template is available on the site. Both the Excel and Google Sheets versions, each built natively for their platform.
